📊 Overall Project Progress in SCC Factory

Saudi Arabia · Tabba II & Qassim II · 6× 24" 2500# Check Valves

📄 Ringo Contract: WO-11318 🇸🇦 Tabba II: V1 / V3 / V4 🇸🇦 Qassim II: V2 / V5 / V6
8%
Overall completion (factory only)
Not Started
4
Sandblast
0
Pre-asm
1
Assembly
1
Test/FAT
0
Painting
0
Packing
0
Shipped (out)
0

📈 Gantt Chart: Plan vs Actual

Project span: 2026-06-01 → 2026-08-02 (9 weeks) · Stage 7 Shipped excluded

Planned
Actual (done)
Actual (in progress)
Today (2026-06-12)
Valve
W23 6/1
W24 6/8
W25 6/15
W26 6/22
W27 6/29
W28 7/6
W29 7/13
W30 7/20
W31 7/27
V1 Plan Actual
V2 Plan Actual
V3 Plan Actual
V4 Plan Actual
V5 Plan Actual
V6 Plan Actual
V1
Plan: 2026-06-06 → 2026-07-05 (29d)
Actual: 2026-06-05 → ongoing
V2
Plan: 2026-06-14 → 2026-07-13 (29d)
Actual: 2026-06-12 → ongoing
V3
Plan: 2026-06-22 → 2026-07-18 (26d)
Actual: Not started
V4
Plan: 2026-07-06 → 2026-08-01 (26d)
Actual: Not started
V5
Plan: 2026-06-24 → 2026-07-20 (26d)
Actual: Not started
V6
Plan: 2026-07-06 → 2026-08-01 (26d)
Actual: Not started
V1 Tabba Assembly
41%
1
Ready
2
Sandblast
3
Pre-asm
4
Assembly
5
Test/FAT
6
Painting
7
Packing
8
Shipped
📸 Latest photo
V2 Qassim Pre-assembly
6%
1
Ready
2
Sandblast
3
Pre-asm
4
Assembly
5
Test/FAT
6
Painting
7
Packing
8
Shipped
📸 Latest photo
V3 Tabba Material Ready
0%
1
Ready
2
Sandblast
3
Pre-asm
4
Assembly
5
Test/FAT
6
Painting
7
Packing
8
Shipped
V4 Tabba Material Ready
0%
1
Ready
2
Sandblast
3
Pre-asm
4
Assembly
5
Test/FAT
6
Painting
7
Packing
8
Shipped
V5 Qassim Material Ready
0%
1
Ready
2
Sandblast
3
Pre-asm
4
Assembly
5
Test/FAT
6
Painting
7
Packing
8
Shipped
V6 Qassim Material Ready
0%
1
Ready
2
Sandblast
3
Pre-asm
4
Assembly
5
Test/FAT
6
Painting
7
Packing
8
Shipped

📅 Today's Activity (2026-06-12)

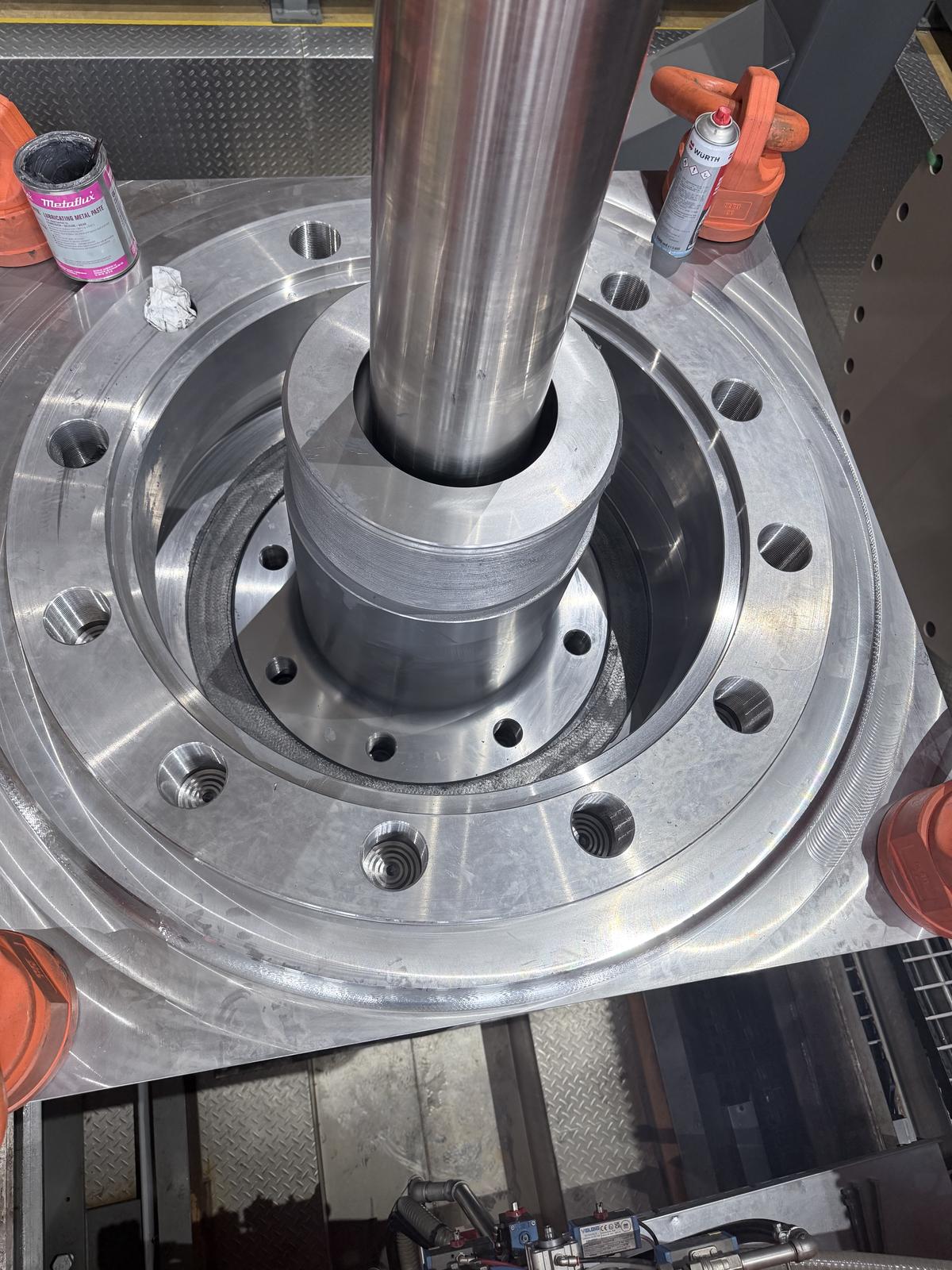

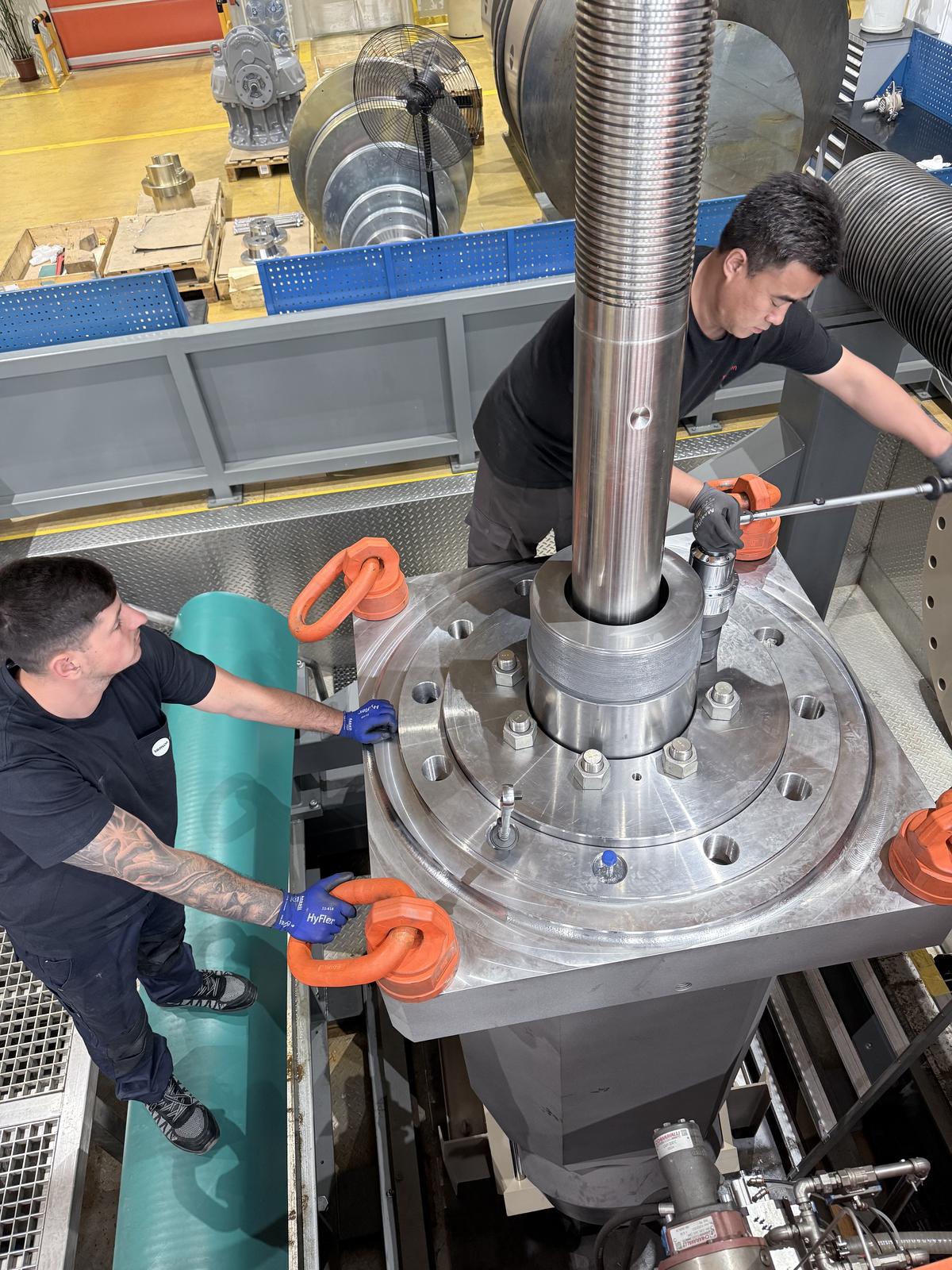

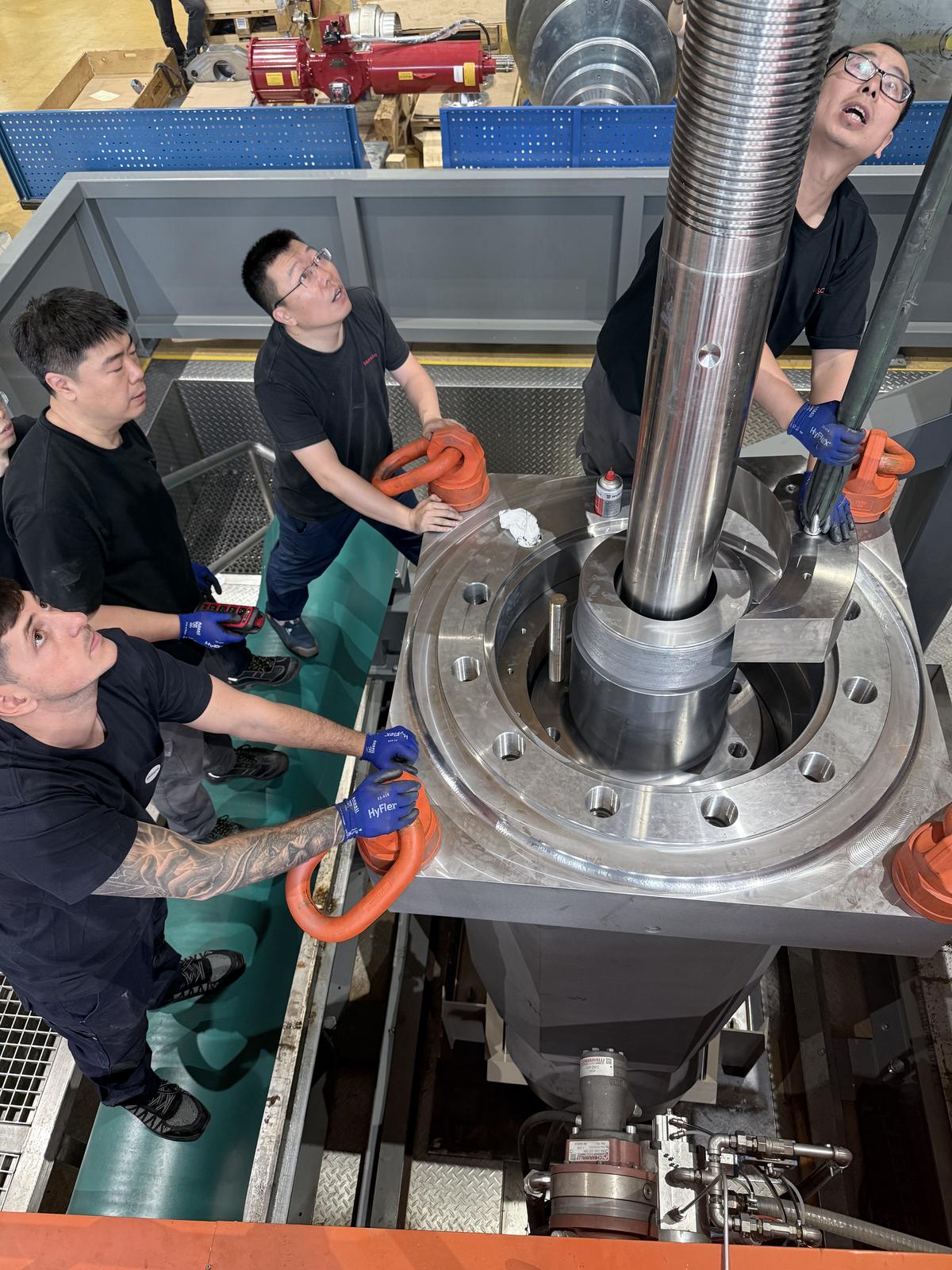

V1, bonnet & stem installed, body gasket, cover, retainer ring installed, bonnet sujection plate installed.
🔧 In progress V1 Stage updated 16:41
✅ Done V1 Stage updated 10:02

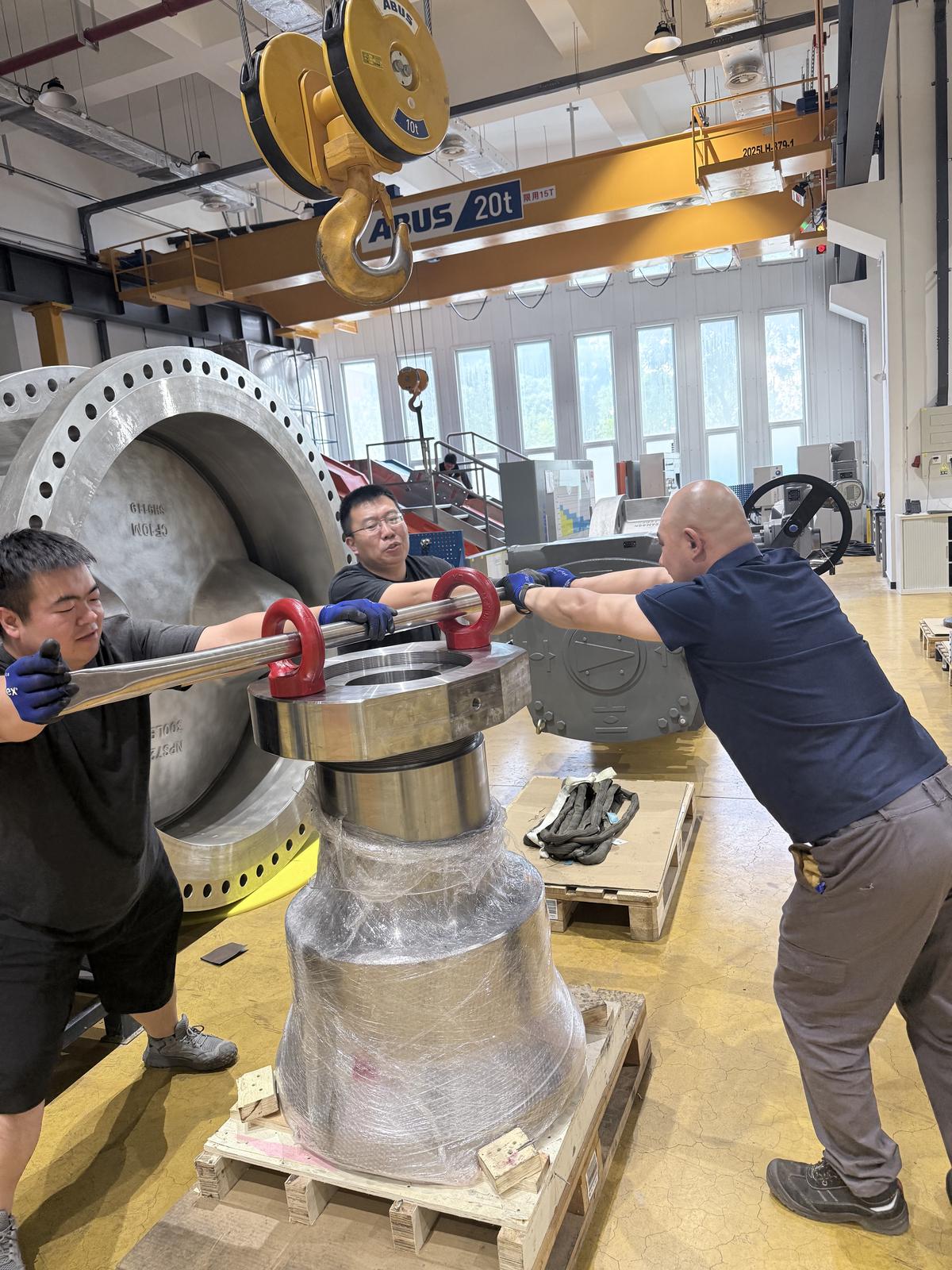

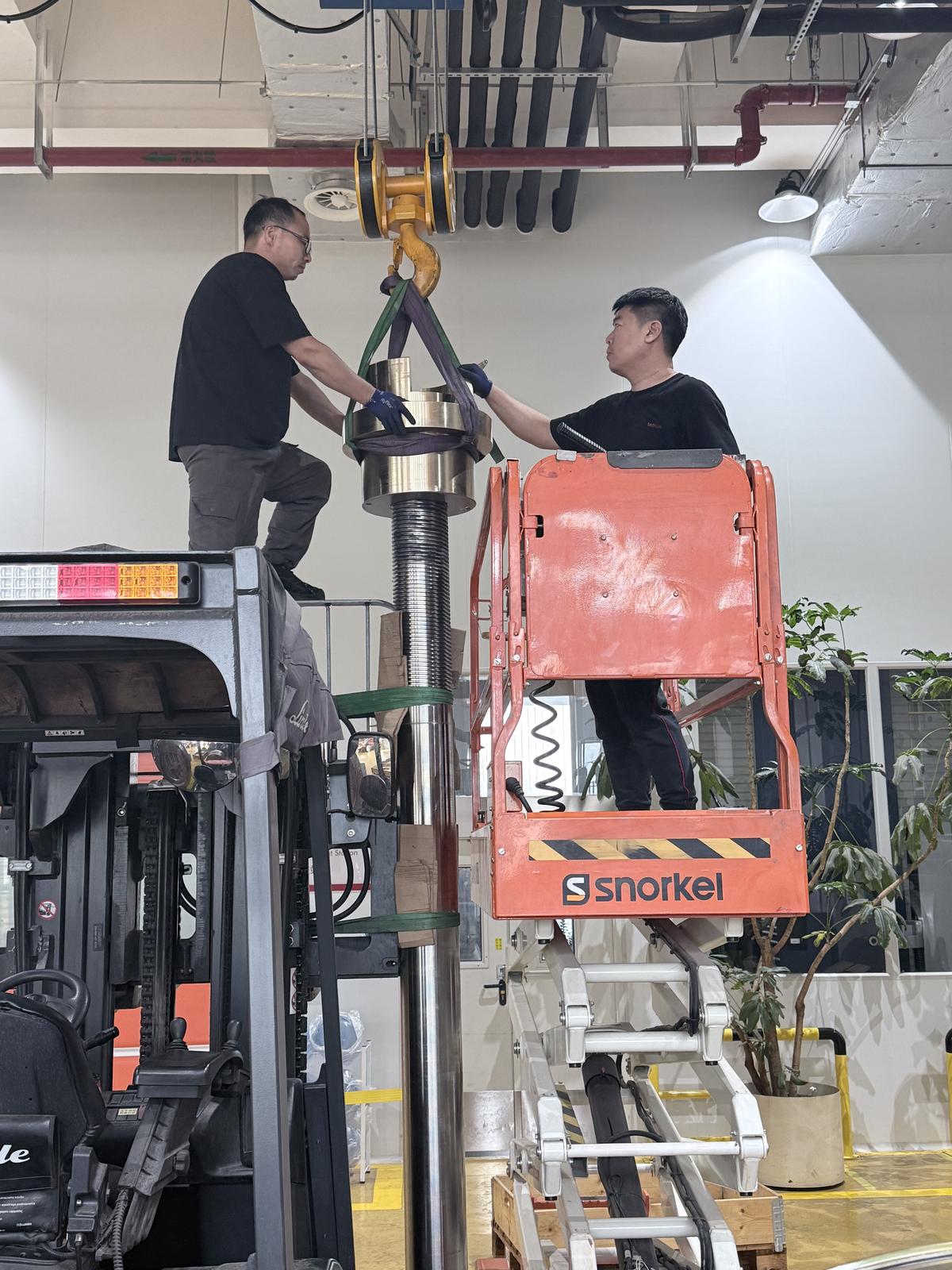

🔧 In progress V2 Stage updated 06:04

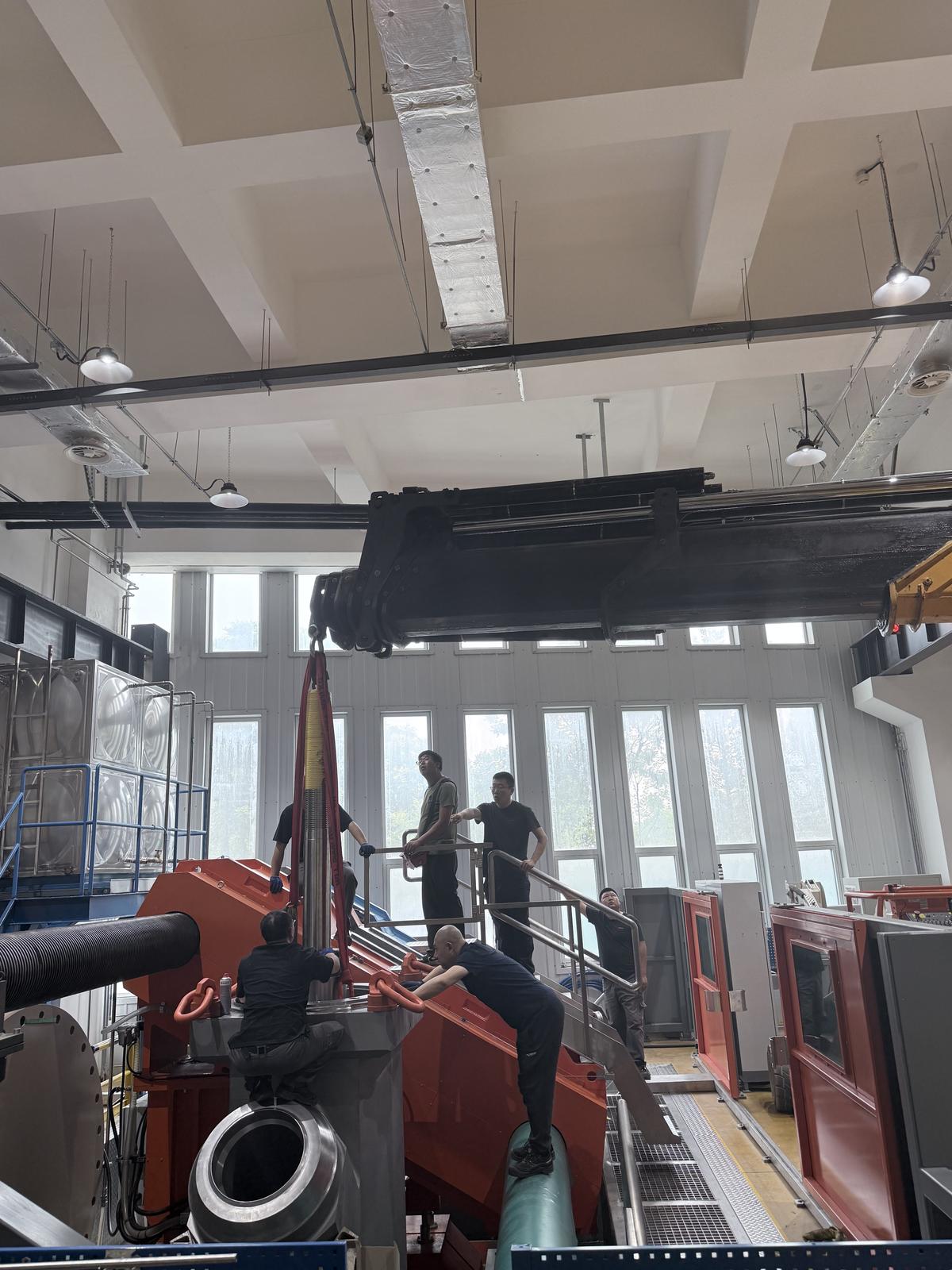

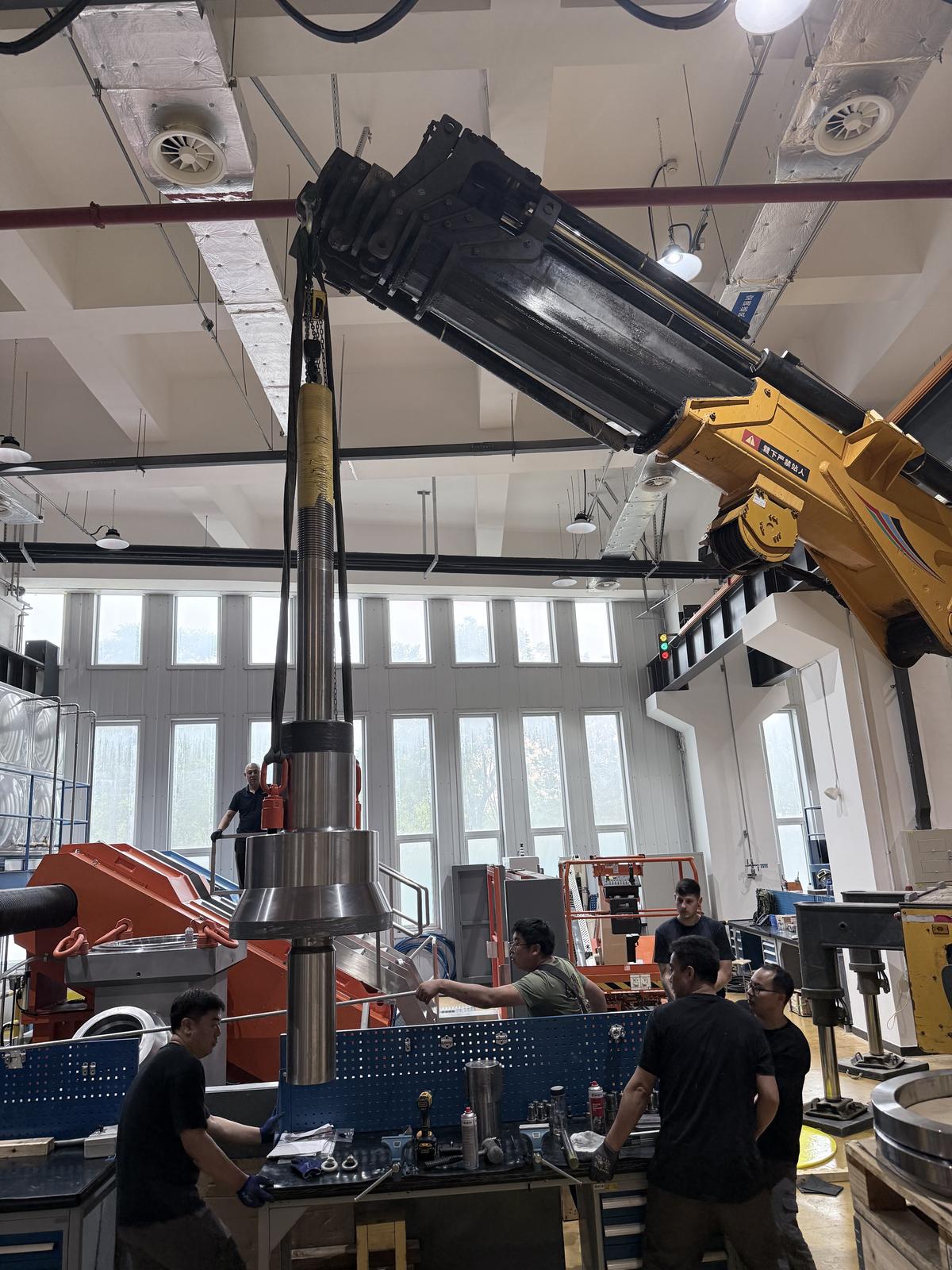

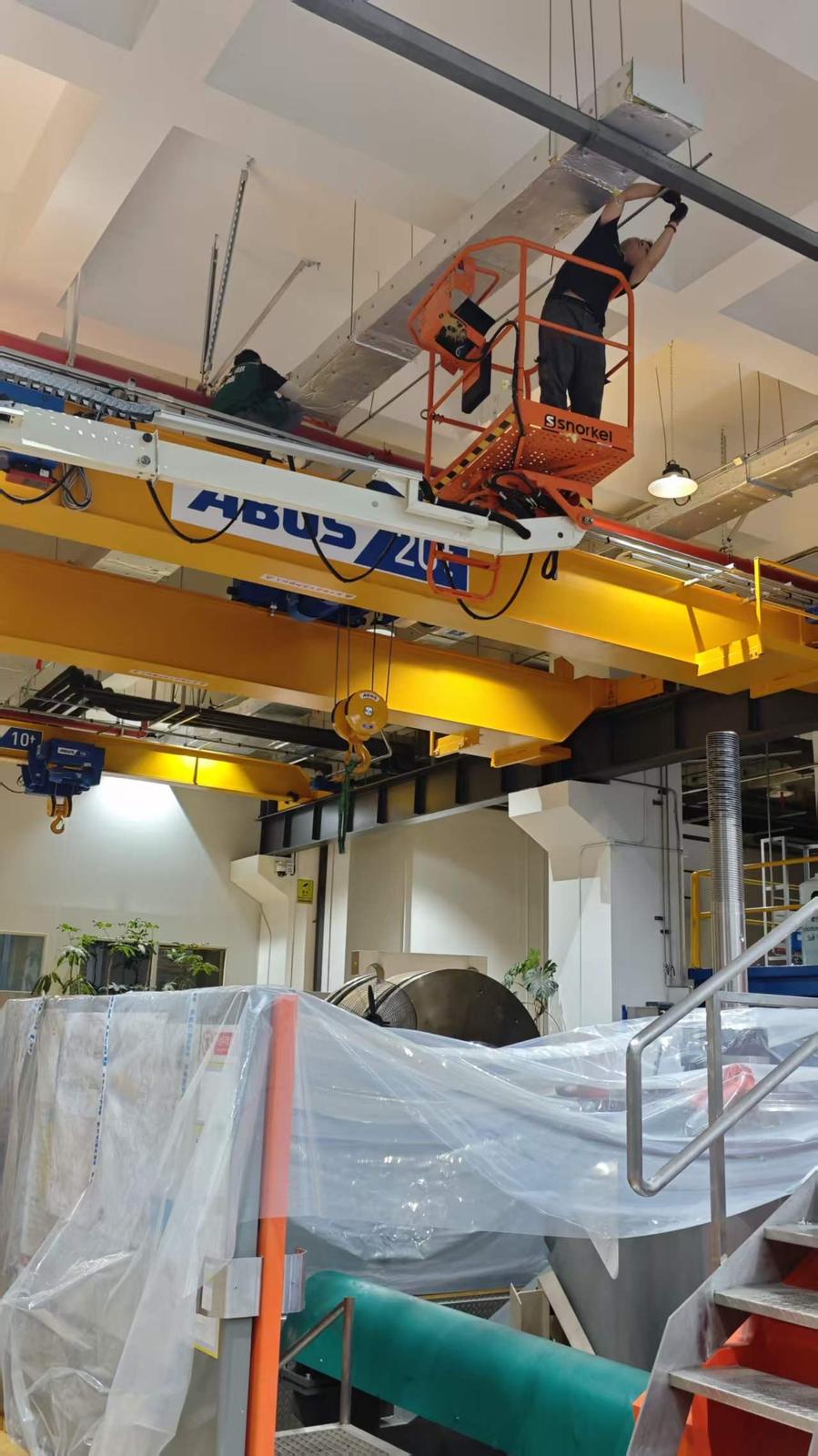

📸 New Photos Today (8)

📥 Export Today's PDF Report
